An AI risk register is the document that turns the NIST AI Risk Management Framework from four verbs into a working record: which AI systems the organization runs, what could go wrong with each, how likely and how severe that is, what has been done about it, and who owns the residual. NIST AI 100-1 does not prescribe a register by name, but its Map, Measure and Manage functions describe exactly the information one holds, and its Govern function requires the risk tolerance and the accountability the register is scored against. This guide sets out the twelve fields an AI risk register needs, the seven risk sources the AI RMF and ISO/IEC 42001 agree on, how to score AI risks when likelihood is not a frequency, and how the register connects to the model inventory, the impact assessment and the incident process.

Free gap assessment
How much of ISO 42001 could you evidence today?
Score every clause and Annex A control of the AI management standard, free, and see where the programme really sits.
Run the free ISO 42001 gap assessment → or View premium report sample
Why an AI risk register is different from an IT one
A cybersecurity risk register records threats to assets with likelihood and impact. An AI risk register records something wider, because the AI RMF defines AI risk as the composite of the probability of an event and the magnitude of its consequences to individuals, organizations and society — including harms the organization does not itself suffer. Three differences follow. The risk sources include the model’s own behaviour (bias, drift, hallucination), not only external threats. The affected parties include people outside the organization, which is why the AI RMF’s Map function asks whose interests are at stake. And likelihood is often not a frequency but a judgement about a system whose behaviour is statistical, which changes how the register is scored. Our guide to the cybersecurity risk register covers the conventional model this one extends.
Free AI risk assessment
Which of your AI systems could harm people, or you?
List your AI systems, models and data, pick from 54 AI risk scenarios, including the attacks on AI described in ISO 27090, rate them for the people affected and for you, and plan treatment with ISO 42001 Annex A controls. You get a heat map, a process score and the findings an auditor would raise, free.
Run the free AI risk assessment → or View premium report sample

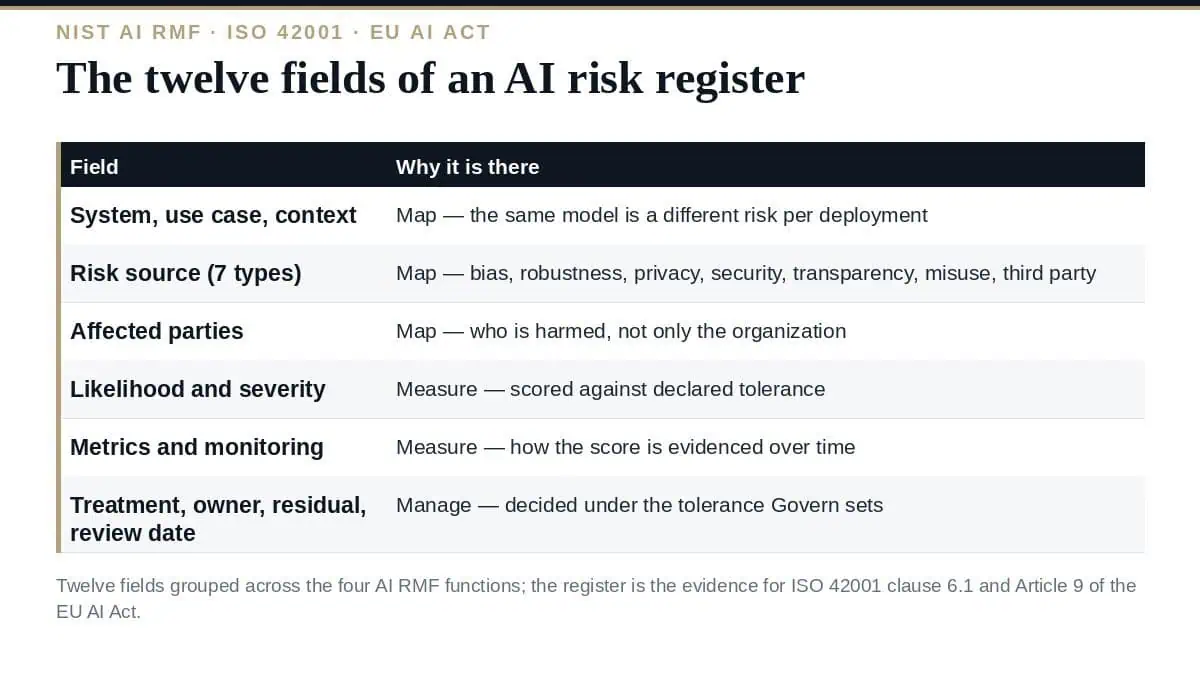

The twelve fields of an AI risk register
| # | Field | AI RMF source | What goes in it |
|---|---|---|---|
| 1 | System ID and name | Map 1 | Link to the AI inventory entry; version; owner |
| 2 | Use case and context | Map 1.1–1.2 | Intended purpose, deployment setting, users, affected parties |
| 3 | Risk statement | Map 5 | Cause, event, consequence: ‘Because X, Y could happen, harming Z’ |
| 4 | Risk source | Map 5; ISO 42001 Annex C | One of the seven sources below |
| 5 | Trustworthiness characteristic affected | AI RMF section 3 | Valid and reliable; safe; secure and resilient; accountable and transparent; explainable and interpretable; privacy-enhanced; fair with harmful bias managed |
| 6 | Affected parties | Map 1.6, 5.2 | Users, subjects, third parties, the organization, society |
| 7 | Likelihood | Measure 2 | A rated judgement with its basis: test results, monitoring data, incident history, expert estimate |
| 8 | Severity | Measure 2 | Magnitude of harm to the affected parties, rated; legal and regulatory exposure noted |
| 9 | Inherent and residual rating | Govern 1.3 tolerance | Rating before and after treatment, against the organization’s AI risk tolerance |
| 10 | Treatment and controls | Manage 1–2 | Avoid, mitigate, transfer, accept; the specific controls, tests and human oversight applied |
| 11 | Metrics and monitoring | Measure 1, 3 | The metric that shows the risk is controlled, its threshold, its frequency, its owner |
| 12 | Owner, status, review date | Govern 2; Manage 4 | Accountable role; open/treated/accepted; next review and trigger events |
The seven AI risk sources
The AI RMF’s Map function and ISO/IEC 42001’s Annex C describe risk sources in overlapping terms; combining them gives a checklist that catches most of what an AI system can do wrong.
| Risk source | Typical risks | Where it shows up |
|---|---|---|
| Data quality and provenance | Training data unrepresentative, mislabelled, stale, obtained without rights; data leakage into training | Bias findings; legal exposure; performance drift |
| Model performance and reliability | Accuracy below requirement in production; degradation over time; failure on edge cases; hallucination in generative models | Wrong outputs acted on; safety incidents |
| Bias and fairness | Disparate outcomes across protected groups; proxy discrimination | Regulatory action; individual harm |
| Security and adversarial | Prompt injection, data poisoning, model extraction, evasion, supply chain compromise of models or libraries | Confidentiality and integrity failures |
| Transparency and explainability | Decisions that cannot be explained to the affected person or the regulator; undisclosed AI use | Legal obligations (EU AI Act Article 50, GDPR Article 22); loss of trust |
| Human oversight and misuse | Over-reliance on outputs; oversight that cannot intervene in time; use outside intended purpose | Automation bias; scope creep into high-risk uses |
| Third-party and lifecycle | Foundation model changes without notice; vendor terms; decommissioning without records | Loss of control over the system’s behaviour |
Scoring AI risks
Likelihood in an AI risk register has three legitimate bases, and the register should say which was used: measured — a test or monitoring metric (false positive rate on the holdout set, disparity ratio in production); observed — incident and near-miss history for this or a comparable system; or estimated — expert judgement, with the estimator named. Severity is rated on the magnitude of harm to the affected parties, and for AI the scale needs a legal column: a risk that engages the EU AI Act’s high-risk obligations, a GDPR Article 22 decision, or a sector regulator’s rules is severe regardless of the number of people affected. The AI RMF’s Govern 1.3 requires the organization to define its risk tolerance; the register applies it as the line between accepted residual risk and risk that must be treated further. Our guide to the NIST AI RMF Playbook covers the suggested actions behind each of these subcategories.
Connecting the register to the rest of the program
- AI inventory. Every system in the inventory has at least one register entry; a system with none has not been mapped. Field 1 is the join.
- Impact assessment. The AI impact assessment (ISO/IEC 42005, AI RMF Map 5) identifies the affected parties and the potential harms; its findings are the register’s fields 3, 6 and 8. Our guide to the AI system impact assessment covers the method.
- Testing and monitoring. Measure produces the metrics in field 11; a register whose likelihoods are all “estimated” is one the Measure function has not reached.
- Incident process. An AI incident updates the register: the likelihood basis becomes “observed”, the treatment is reviewed, and new risks are added. Field 12’s trigger events include incidents on this or a comparable system.
- Management review. The register’s top residual risks and the tolerance exceptions are the AI risk input to leadership review — and, for ISO/IEC 42001 certification, evidence for clause 6.1 and 9.3. Our guide to NIST AI RMF implementation places the register in the eight-step plan.
Five mistakes in AI risk registers
- One row per system. A system carries several risks from several sources. “AI risk — chatbot — medium” is an inventory entry, not a risk.
- No affected-party column. The AI RMF’s definition of risk includes harm to individuals and society; a register that scores only organizational impact misses the risks regulators care about.
- Likelihood without a basis. Measured, observed or estimated — say which, or the score cannot be challenged or improved.
- Treatment without a metric. A bias mitigation with no disparity metric and threshold is an intention. Field 11 is what makes field 10 verifiable.
- No trigger for review. Model updates, foundation-model changes, new deployment contexts and incidents all change the risk. A register reviewed annually is stale for most of the year.
Frequently asked questions
Does the NIST AI RMF require an AI risk register?
Not by name. Its Map, Measure and Manage functions describe the information a register holds — context, risks, likelihood and severity, treatment, residual risk and monitoring — and Govern requires the tolerance and accountability the register is scored against. A register is the practical way to evidence all four.
How is an AI risk register different from an IT risk register?
It includes the model’s own behaviour — bias, drift, hallucination — as a risk source, records harm to people outside the organization, and states the basis for each likelihood because AI behaviour is statistical rather than a frequency.
What are the AI risk sources?
Data quality and provenance; model performance and reliability; bias and fairness; security and adversarial; transparency and explainability; human oversight and misuse; third-party and lifecycle — drawn from the AI RMF Map function and ISO/IEC 42001 Annex C.
Can one register serve NIST AI RMF and ISO 42001?
Yes. The fields map onto ISO 42001 clause 6.1 risk assessment and treatment and Annex C’s objectives and sources; the register is the same document with a crosswalk column.
How often should it be reviewed?
On trigger events — model updates, foundation-model changes, new contexts, incidents — and on a scheduled cycle per system, with the top residual risks reported to leadership at management review.
Where this leaves you
Build the AI risk register with twelve fields, one row per risk rather than per system, the seven sources as the checklist, likelihood with its basis stated, severity with a legal column, and a metric behind every treatment. Join it to the inventory, the impact assessment, the monitoring and the incident process, and it becomes the record the AI RMF’s four functions describe — and the evidence an ISO/IEC 42001 auditor or an EU AI Act conformity assessment reads first.
References
- NIST AI Risk Management Framework (AI RMF 1.0) — The Govern, Map, Measure and Manage functions.
- NIST AI RMF Playbook — Suggested actions for each subcategory.
- ISO/IEC 42001:2023 — AI management system requirements, including Annex C risk sources and objectives.
More on AI governance
- The AI risk register — you are here
- NIST AI RMF: the four functions
- NIST AI RMF implementation in 8 steps
- The NIST AI RMF Playbook
- AI system impact assessment
- The seven trustworthy AI characteristics
The AI Risk Register and Risk Treatment Plan templates, the AI Inventory and Use Case Register, the AI Impact Assessment procedure and the AI Risk Tolerance and Acceptance Criteria document are in the NIST AI RMF Toolkit (36 templates), or start with the free templates.
