ISO Compliance Insights & Best Practices

whole life cost explained

Whole Life Cost: 7 Essential Elements for ISO 55001 Decisions

Whole life cost is the total cost of an asset from the decision to acquire it to the decision to dispose of it — acquisition, operation, maintenance, renewal, downtime and end of life — discounted to a common basis so that options with different cost profiles can be compared. It is the arithmetic behind the value principle in ISO 55000:2024 and the decision-making clause ISO 55001:2024 added at 4.5: an organisation that must document how it decides between investing, maintaining, deferring and disposing needs a cost model that runs over the asset’s life, not over the current budget year.

It is also where asset management and finance most often talk past each other, which is why ISO/TS 55010:2024 exists. This guide sets out the seven cost elements a whole life cost model needs, how to build one for a decision, the discounting and horizon choices that change the answer, where the model connects to ISO 55001’s clauses, and the five errors that make whole-life comparisons wrong.

Whole life cost: the seven elements and the decision it feeds
Acquisition · installation and commissioning · operation · maintenance · renewal and major intervention · downtime and consequence · end of life — discounted over the life to compare options under ISO 55001 clause 4.5.

Why ISO 55001 needs it

ISO 55001:2024’s foreword lists among its changes a new subclause on asset management decision-making and the clarification that operational planning and control includes life cycle management. Clause 4.5 asks for a documented approach to decisions with criteria; clause 8.1 asks for the life cycle to be managed; clause 6.2 asks for objectives that balance cost, risk and performance.

None of those can be met with initial-cost comparisons, because the cheapest asset to buy is frequently the most expensive to own. Whole life cost is the method that lets the criteria in 4.5 be applied consistently, and it is the language finance recognises once the two functions are aligned. Our guide to ISO 55001:2024 covers the clauses; this guide covers the model.

The seven whole life cost elements

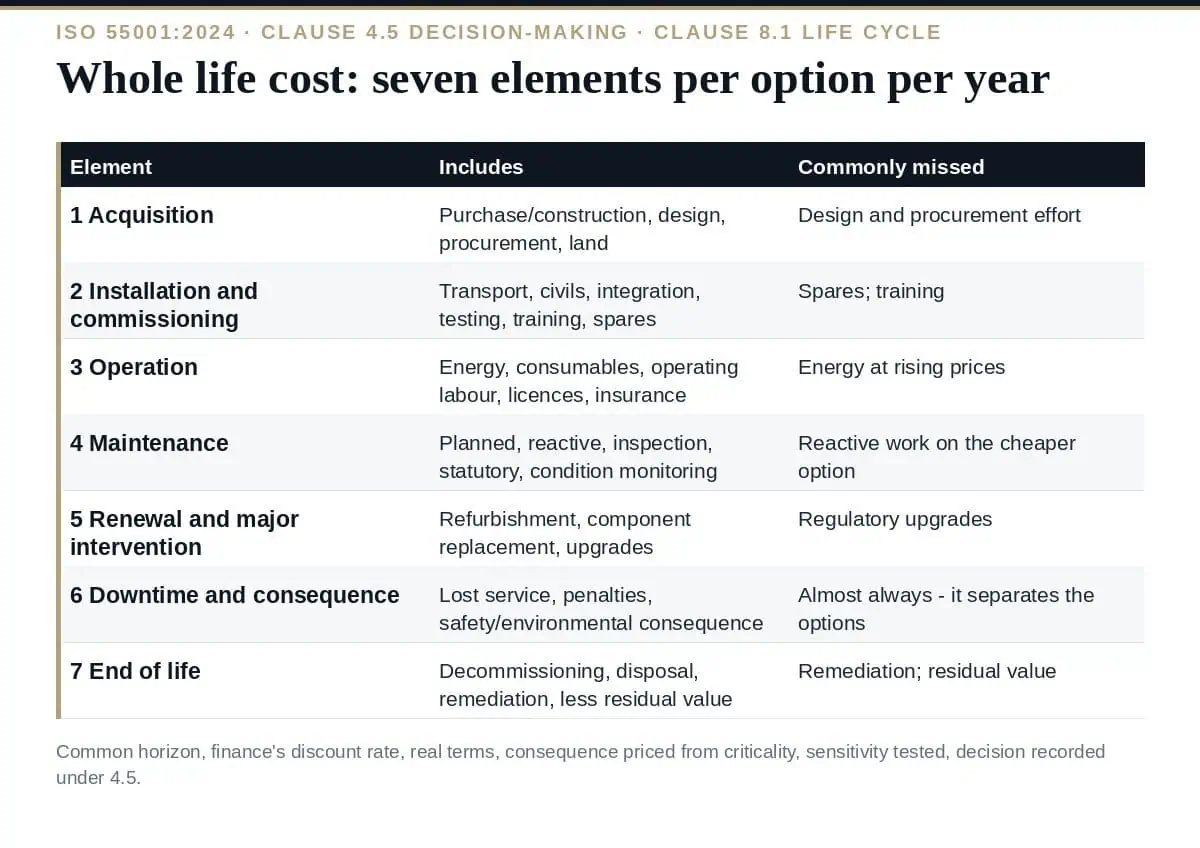

Element What it includes Where the data comes from Commonly missed
1. Acquisition Purchase or construction price, design, procurement, land and rights Capital budget, contracts Design and procurement effort
2. Installation and commissioning Transport, civil works, integration, testing, training, spares Project accounts Spares holding; training
3. Operation Energy, consumables, labour to operate, licences, insurance Operating budget, metering Energy over life at rising prices
4. Maintenance Planned and reactive maintenance, inspection, statutory testing, condition monitoring CMMS history, contracts Reactive maintenance for the cheaper option
5. Renewal and major intervention Mid-life refurbishment, component replacement, upgrades to meet new requirements Engineering plans, OEM guidance Regulatory upgrades
6. Downtime and consequence Lost production or service, penalties, safety and environmental consequence of failure, reputational cost Reliability data, service agreements Almost always — it is the element that separates options
7. End of life Decommissioning, removal, disposal, remediation, less residual or resale value Disposal contracts, regulations Remediation; residual value as a negative cost

Element 6 is the one that turns whole life cost from an accounting exercise into an asset management one. Two pumps with identical purchase, operating and maintenance costs but different failure rates have different whole-life costs only if the consequence of failure is priced — which requires the criticality assessment the register holds. Our guide to asset criticality covers that input.

Building the model for a decision

  1. Define the decision and the options. Replace now, refurbish, defer two years, replace with a different technology. The model compares options; it does not value an asset in isolation.
  2. Set the horizon. The longest option’s life, or a common study period with residual values for options that outlast it. Mismatched horizons are the first source of wrong answers.
  3. Build the cost profile per option, per year, across the seven elements, in today’s money.
  4. Discount. Apply the organisation’s discount rate — usually finance’s cost of capital or a public-sector test rate — to bring each year’s cost to present value; sum for net present cost.
  5. Add risk explicitly. Failure probability times consequence, by year, for element 6; or run scenarios.
  6. Test sensitivity. Discount rate, energy price, failure rate and life estimate; if the ranking flips within plausible ranges, say so.
  7. Record the decision under clause 4.5 with the model, the assumptions and the criteria applied.

The choices that change the answer

Choice Effect What to do
Discount rate A high rate favours options with low initial cost and high later cost; a low rate favours durable, expensive-to-buy options Use finance’s rate; show the result at a second rate
Horizon Truncating at the shorter option’s life hides the renewal the longer option avoids Common study period with residual values, or lowest common multiple of lives
Inflation treatment Mixing real and nominal cash flows with a real discount rate misprices energy and labour Model in real terms with real escalation where an element outpaces general inflation
Consequence pricing Leaving element 6 out makes reliability worthless in the model Price downtime from service levels and contracts; price safety and environmental consequence by the organisation’s risk criteria
Residual value Ignoring it penalises options with life remaining at the horizon Straight-line or market residual, stated

Where finance and asset management diverge

Finance measures assets by book value, depreciation and capital versus operating spend; asset management measures them by condition, criticality, performance and whole-life cost. ISO/TS 55010:2024 gives guidance on aligning the two — shared asset registers, capital investment planning and long-term financial planning that draw on the same data. In practice the alignment needs three agreements: a shared asset identifier and hierarchy, an agreed discount rate and horizon convention, and a rule that capital approval papers show whole-life cost alongside initial cost. Without the third, the policy commitment to value is contradicted by the approval form. Our guide to the asset register covers the shared identifier.

Five errors that make whole life cost wrong

  • Comparing options over different lives without residual values or a common period.
  • Using purchase-year prices for twenty years of energy.
  • Omitting downtime and consequence, so reliability never wins.
  • Discounting nominal cash flows at a real rate or the reverse.
  • Treating the model as the decision. Clause 4.5 asks for criteria — the figures inform a decision that also weighs risk appetite, service obligations and stakeholder value.

Frequently asked questions

What is whole life cost?
The total cost of an asset over its life — acquisition, installation, operation, maintenance, renewal, downtime and consequence, and end of life less residual value — discounted to present value so that options with different cost profiles can be compared. It is the method behind ISO 55001:2024’s decision-making clause 4.5 and life-cycle management under 8.1.

Is it the same as life-cycle costing?
The terms are used interchangeably in asset management; some conventions treat life-cycle cost as the owner’s costs and whole life cost as adding wider consequence and externalities. State which elements the model includes.

What discount rate should we use?
The organisation’s cost of capital or, in the public sector, the mandated test rate; agree it with finance and show sensitivity to a second rate.

How does it relate to the asset register?
The register supplies age, condition, criticality, value and history; the model consumes them. ISO/TS 55010:2024 recommends aligning the financial and non-financial registers so the model and the capital plan use the same data.

Does ISO 55001 require a specific method?
No. It requires a documented decision-making approach with criteria (4.5) and life-cycle management (8.1); whole life cost is the established method for meeting both.

Where this leaves you

Build whole life cost as the engine of ISO 55001 decisions: seven elements per option per year, a common horizon, finance’s discount rate, consequence priced from criticality, sensitivity tested, and the result recorded under clause 4.5. Then get the capital approval form to show it, because the model only changes decisions if the people approving spend can see it.
