Stakeholder Register: A Clear Guide to All 7 Fields

A stakeholder register is the list of everyone who can affect your project or be
affected by it, with enough recorded against each name to act on. Kept properly it is a working tool.
Kept the usual way — a spreadsheet of job titles produced at initiation and never reopened
— it is a compliance artefact that predicts nothing.

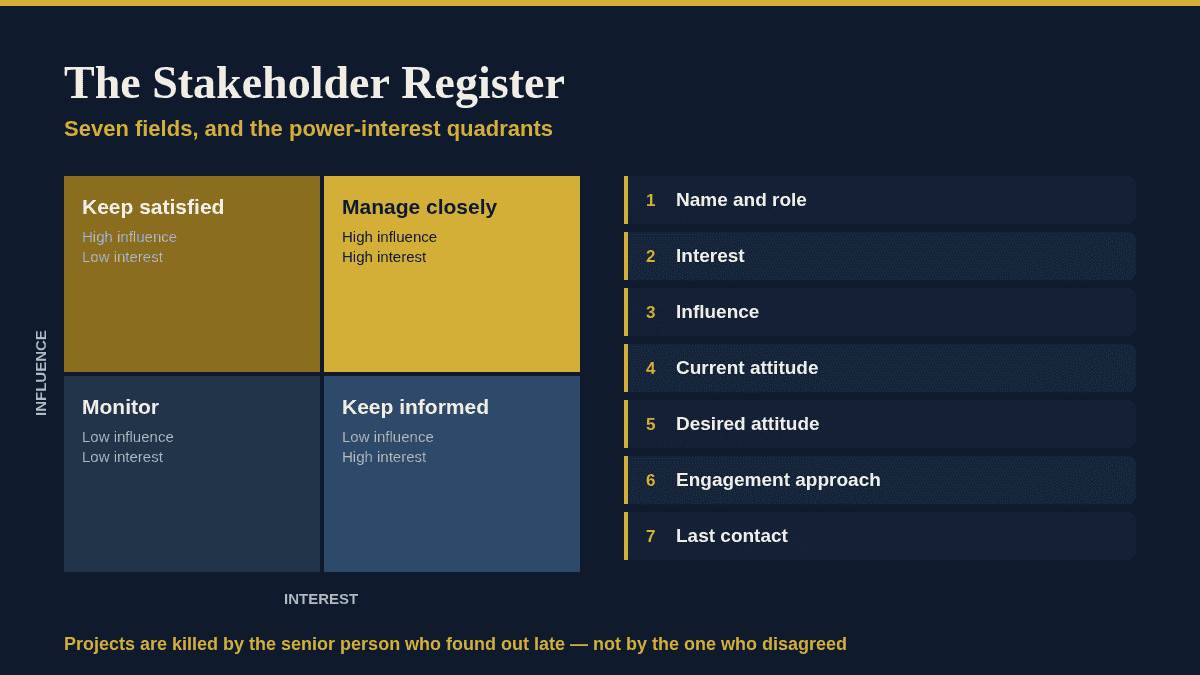

Stakeholder register: the seven fields and the power-interest quadrants
The seven fields of a stakeholder register, and the four power-interest quadrants.

What a stakeholder register records

Seven fields do the work. Anything less and the register cannot drive behaviour; much more and it
stops being maintained.

Field Why it earns its column
Name and role Individuals, not departments — “Finance” cannot be consulted
Interest What they actually want from this, in their words
Influence What they can do to you — approve, block, delay, resource
Current attitude Supportive, neutral, resistant — today, not at kick-off
Desired attitude Where you need them to be, which is often just “not blocking”
Engagement approach What you will do, how often, and who owns the relationship
Last contact A date, which instantly exposes who has been neglected

The pair of attitude columns is what turns the register from a description into a plan. Recording
that a director is resistant is an observation; recording that you need them neutral by the design
gate, and how you intend to get there, is management.

Power and interest, and what to do with each quadrant

Plotting stakeholders on influence against interest gives four groups and four different jobs.
High influence, high interest are managed closely — they belong in governance
and get individual attention. High influence, low interest are the dangerous ones:
they can stop the project and are not paying attention, so they need to be kept satisfied and never
surprised. Low influence, high interest are your most useful volunteers, worth
keeping informed and often worth recruiting as advocates. Low influence, low interest
get monitored, cheaply.

The quadrant that causes damage is the second. Projects are rarely killed by a stakeholder who was
engaged and disagreed; they are killed by a senior person who found out late and reacted badly.

The register is confidential, and that has consequences

A document recording that a named director is resistant is not something to circulate or attach to
a status pack. Keep it access-controlled, write assessments in professional terms you would be
comfortable defending, and remember that most organisations are subject to data protection obligations
covering personal data held about identifiable individuals — a stakeholder register qualifies.
Assess attitudes towards the project, never the person.

Groups need a named representative

Some stakeholders are genuinely collective — a customer segment, a user community, a union
membership. You cannot hold a relationship with a group, so the register needs a named representative
against each: the person who speaks for them, and who you will actually talk to.

Where no such person exists, that is a finding rather than a formatting problem. A project changing
how two hundred people work, with nobody empowered to represent them, will discover their view during
user acceptance testing at the worst possible moment. Identifying the gap early gives you time to ask
for a representative to be appointed.

Keeping a stakeholder register alive

  1. Build it in a workshop, not at a desk. The people who know who really decides
    things are rarely the people who write the register.
  2. Ask who is missing, twice. The most costly stakeholder is the one nobody
    listed — typically in operations, support, compliance or a customer group.
  3. Name individuals. If you cannot name them, you have identified a gap, not a
    stakeholder.
  4. Assign relationship owners. The project manager cannot personally hold thirty
    relationships; the sponsor should carry the senior ones.
  5. Review it monthly, and after any reorganisation. A restructure invalidates a
    register instantly, and nobody sends a notification.
  6. Drive the communications plan from it. If your engagement approach column and
    your comms plan disagree, one of them is not being used.

Watch the leaving indicators

Two columns predict trouble if you actually read them. A last contact date more
than a month old against a high-influence stakeholder is a warning. And a current
attitude
that has moved the wrong way since last review is worth more than any status RAG,
because attitudes shift before problems become visible in the schedule.

This is also the discipline that makes benefits stick. Benefit owners are stakeholders, and a
benefit whose owner has drifted into disengagement will not be tracked after closure — which is
why benefits realisation and stakeholder
engagement fail together more often than either fails alone.

Thirty-nine stakeholder and communications templates.

The Project Management Toolkit ships 390+ editable MS Office templates. The stakeholder set covers a stakeholder register, a power-interest matrix, stakeholder mapping, a stakeholder management plan and communication plan, a satisfaction survey, a decision register and the status report and meeting formats the engagement plan drives.

Explore the Project Management Toolkit →

Where the stakeholder register sits in the standards

PMI’s PMBOK Guide
reached its Eighth Edition in November 2025 and carries stakeholders as one of its seven performance
domains — alongside governance, scope, schedule, finance, resources and risk. The
ISO 21502:2020
guidance treats stakeholder engagement as a practice in its own right, and
PRINCE2 7, current since 4 September 2023, made people the fifth integrated element of
the method.

The common thread is that stakeholder work has been promoted from a soft skill to a managed
discipline with its own artefacts. The register is the artefact.

Finding the stakeholders nobody listed

A stakeholder register is only as good as the identification behind it, and the initial pass almost
always finds the obvious people while missing the ones who cause trouble. Four prompts consistently
surface names a first workshop misses.

  • Who has to change how they work? Not who benefits — who has to do something
    differently. That group is the source of most resistance and is regularly absent from the register.
  • Who supports it after go-live? Service desk, operations and support teams are
    stakeholders in a project they are usually shown at the end.
  • Who can say no? Compliance, information security, data protection, legal,
    procurement, health and safety. Any one can stop delivery, and each tends to be consulted late.
  • Who is affected outside the organisation? Customers, suppliers, regulators,
    unions. External stakeholders rarely appear on a first draft and are the hardest to recover from.

Ask the same four questions again a month later. Projects acquire stakeholders as they become
visible, and a register frozen at initiation describes the project you thought you were running.

A stakeholder register is not a substitute for talking to people

Worth stating, because the artefact can become the activity. Filling in an influence column is not
engagement, and a register with every field populated and no conversations behind it is a well-formatted
guess.

The register’s real value is that it makes neglect visible. It surfaces the person you have been
avoiding, the relationship that has had no contact in six weeks, and the senior stakeholder everyone
assumed somebody else was handling. Those are uncomfortable things to see written down, which is
precisely why the register earns its place.

Frequently asked questions

What is a stakeholder register?
A controlled list of everyone who can affect or be affected by the project, recording their interest,
influence, current and desired attitude, engagement approach and last contact.

How is it different from a communications plan?
The register records who people are and what they need; the communications plan schedules what gets
sent to whom and when. The plan should be derived from the register.

Who should be able to see it?
The project manager, the sponsor, and relationship owners. It records opinions about named
individuals, so it is not a document for general circulation.

How often should it be reviewed?
Monthly as a minimum, and immediately after any organisational change. Reorganisations invalidate
registers faster than anything else.

What if a stakeholder stays resistant?
Escalate to the sponsor with a specific ask. Persistent resistance from someone with real influence is
a project-level risk and belongs in the RAID log, not in a quiet column nobody reads.

Where this leaves you

A stakeholder register is a management tool that happens to look like a spreadsheet. Name
individuals rather than departments, record current and desired attitude so the document plans rather
than describes, assign relationship owners because no project manager holds thirty relationships
alone, and put a last-contact date against every line so neglect becomes visible.

Then review it monthly and after every reorganisation, and ask the four identification questions
again each time. The stakeholder who sinks a project is almost never the one being managed closely
— it is the senior person with real influence and no interest, who found out late. The register
exists to make sure that person has a name, an owner and a date.
